Time schedule
TIME PLAN 18th cz Extreme Euro Open 2027
| sat | 29.5.2027 | 15:00 -18:00 | Registration to Prematch, guncheck/equipment check (on the shooting range) |
| 20:00 | Welcome dinner for CRO&RO | ||

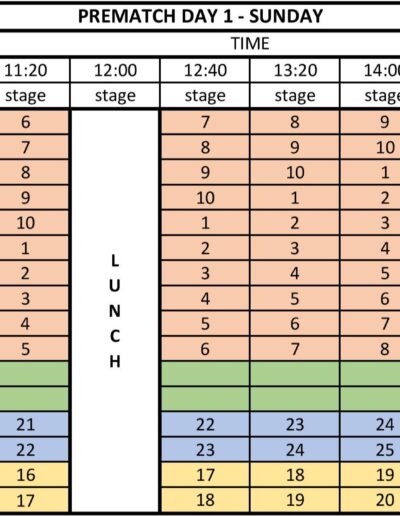

| sun | 30.5.2027 | 8:30-18:00 | Prematch DAY 1 |

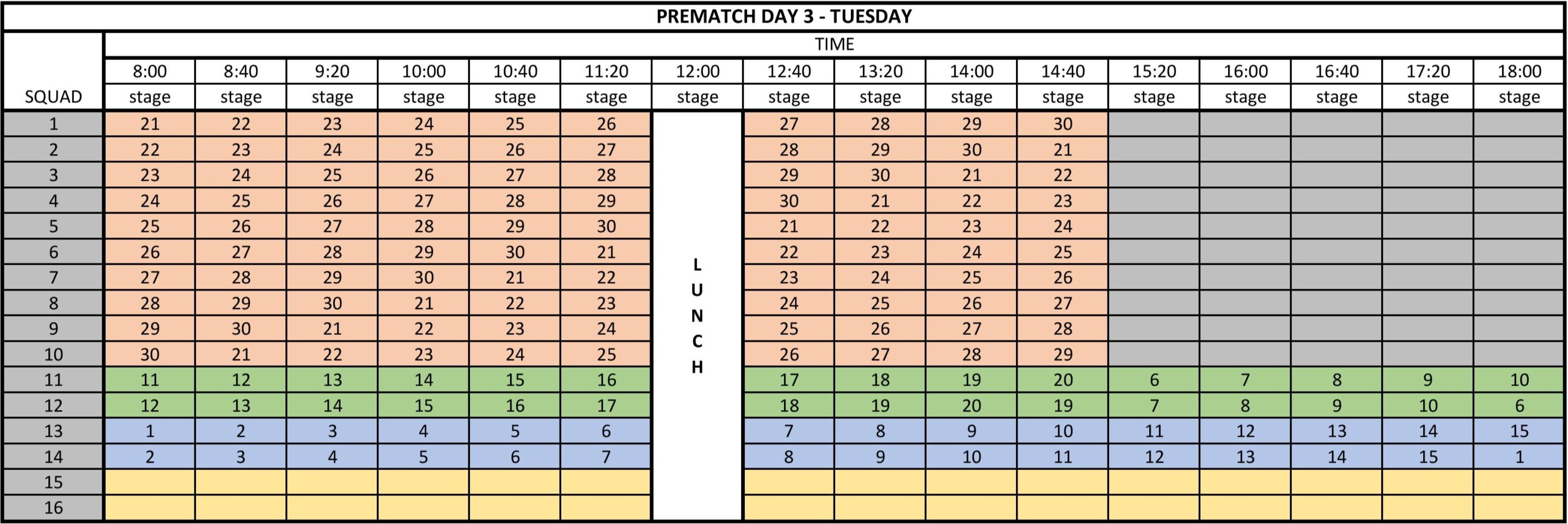

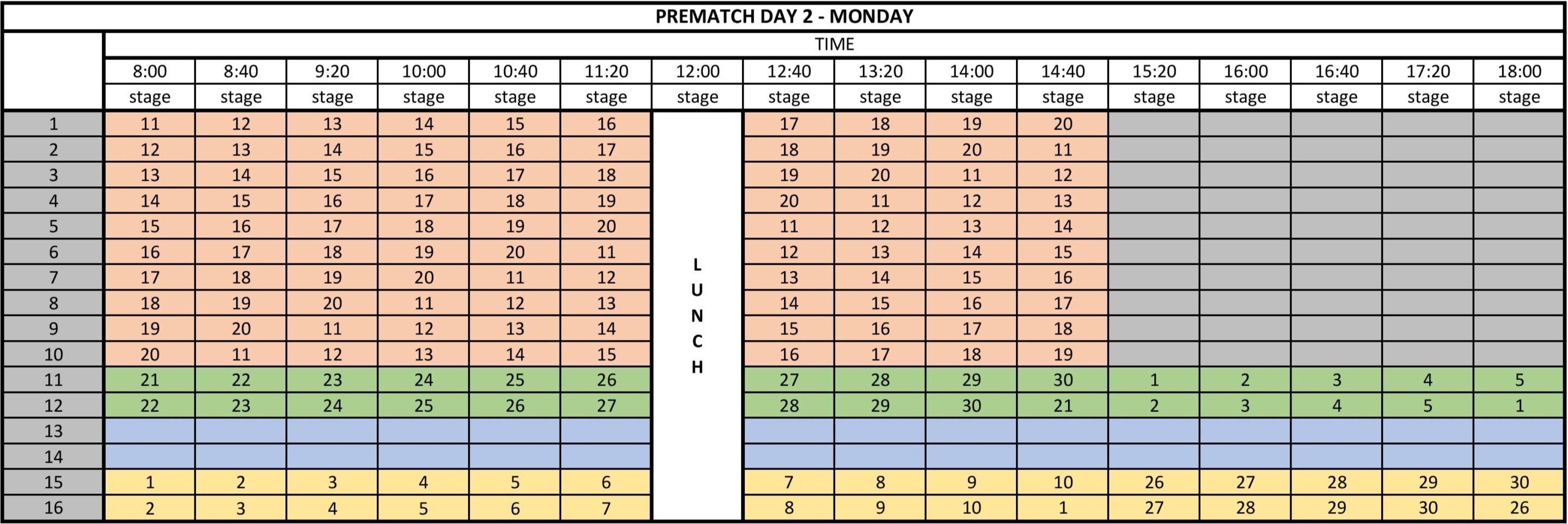

| mon | 31.5.2027 | 8:30-18:00 | Prematch DAY 2 |

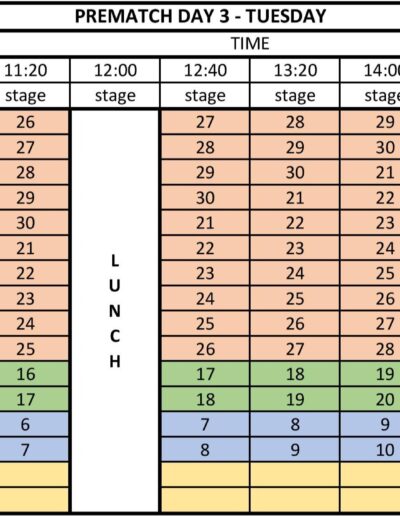

| tue | 1.6.2027 | 8:30-18:00 | Prematch DAY 3 |
| 20:00 | RO briefing & barbecue (HotelN) | ||
| wed | 2.6.2027 | 11:00-18:00 | Registration to Main Match, gun check/equipment check (on the shooting range) |

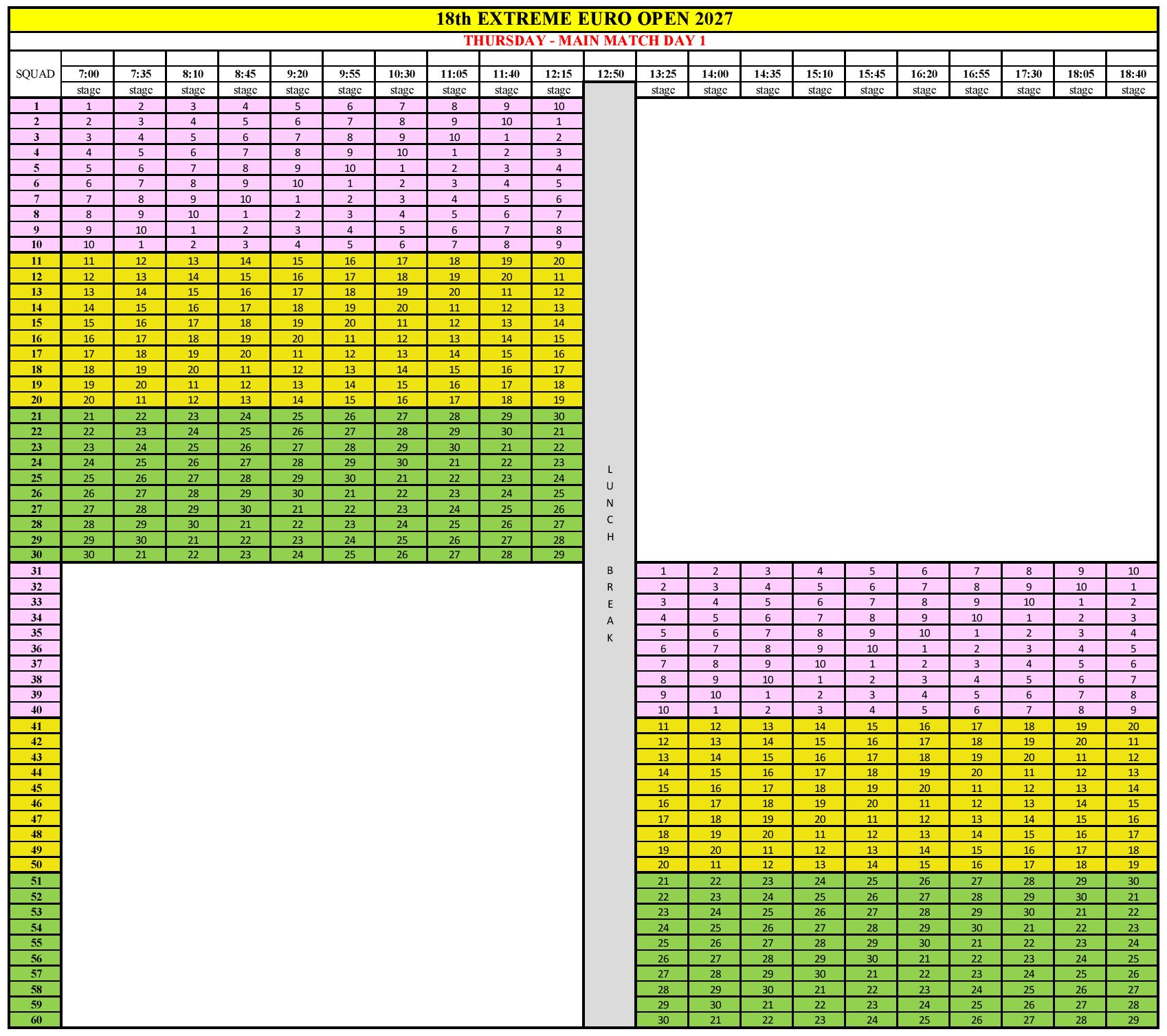

| thu | 3.6.2027 | 07:00 | Mainmatch DAY 1 / M-01 » M-30 |
| 13:25 | M-31 » M-60 | ||

| fri | 4.6.2027 | 07:00 | Mainmatch DAY 2 / M-31 » M-60 |
| 13:25 | M-01 » M-30 | ||

| sat | 5.6.2027 | 07:00 | Mainmatch DAY 3 / M-01 » M-30 |
| 13:25 | M-31 » M-60 | ||
| sat | evening | 1h after last shot | Awarding Ceremony, Party |
| sun | 6.6.2027 | - - - | - - - |

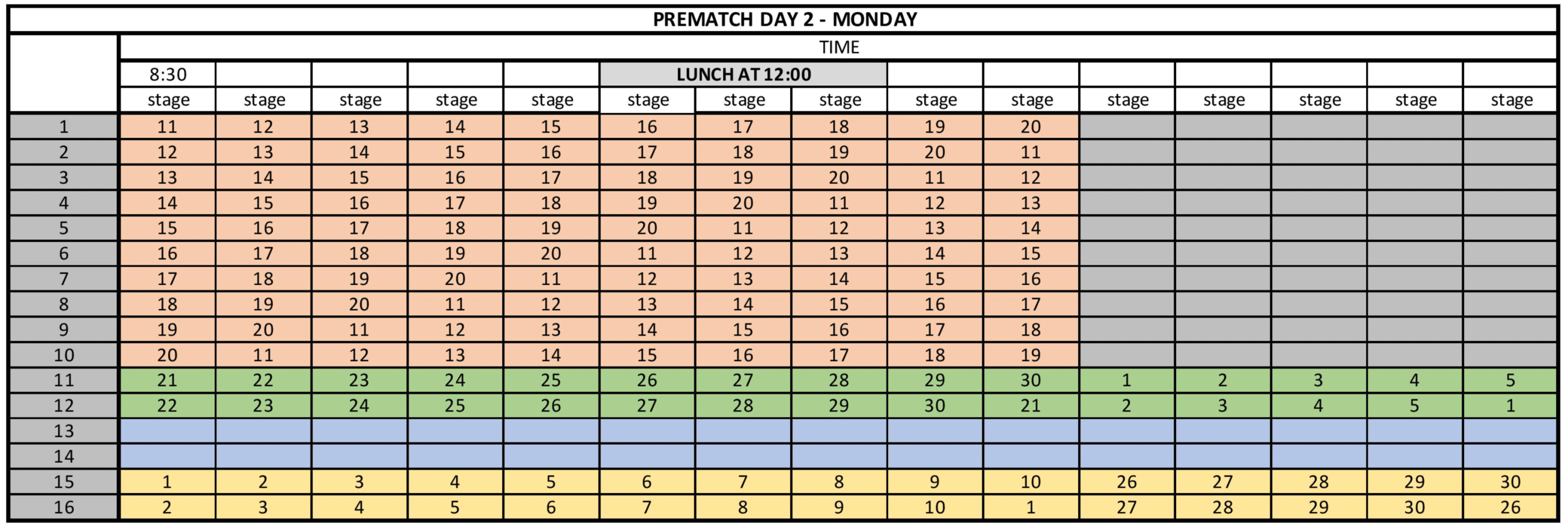

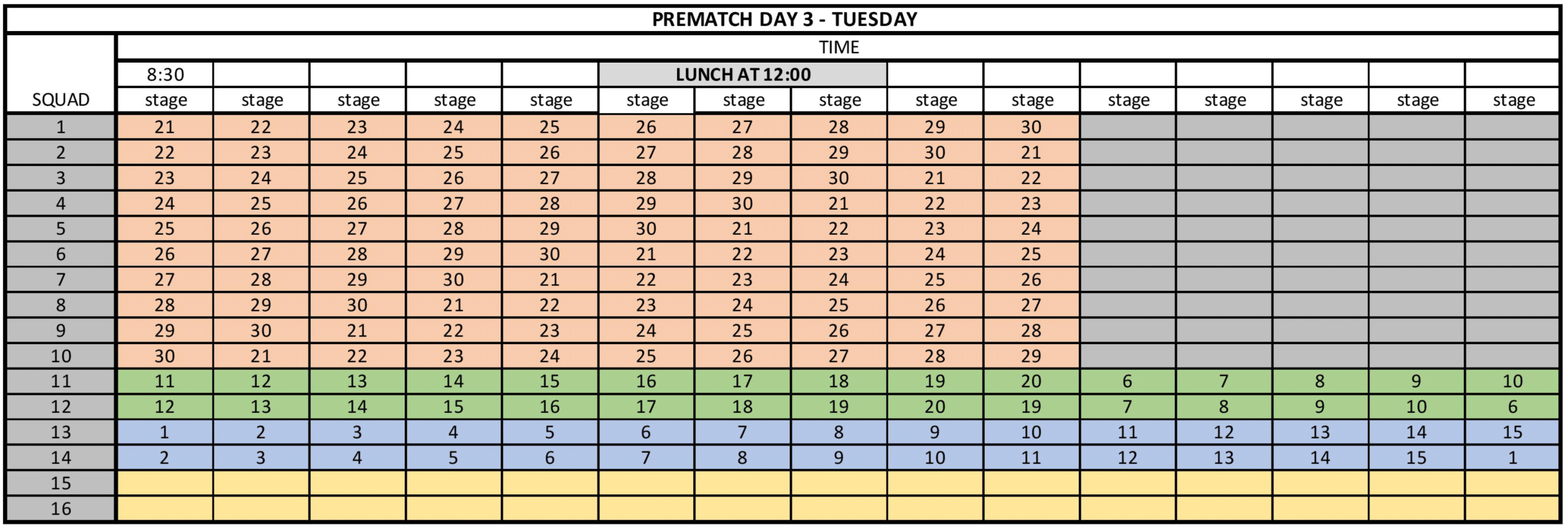

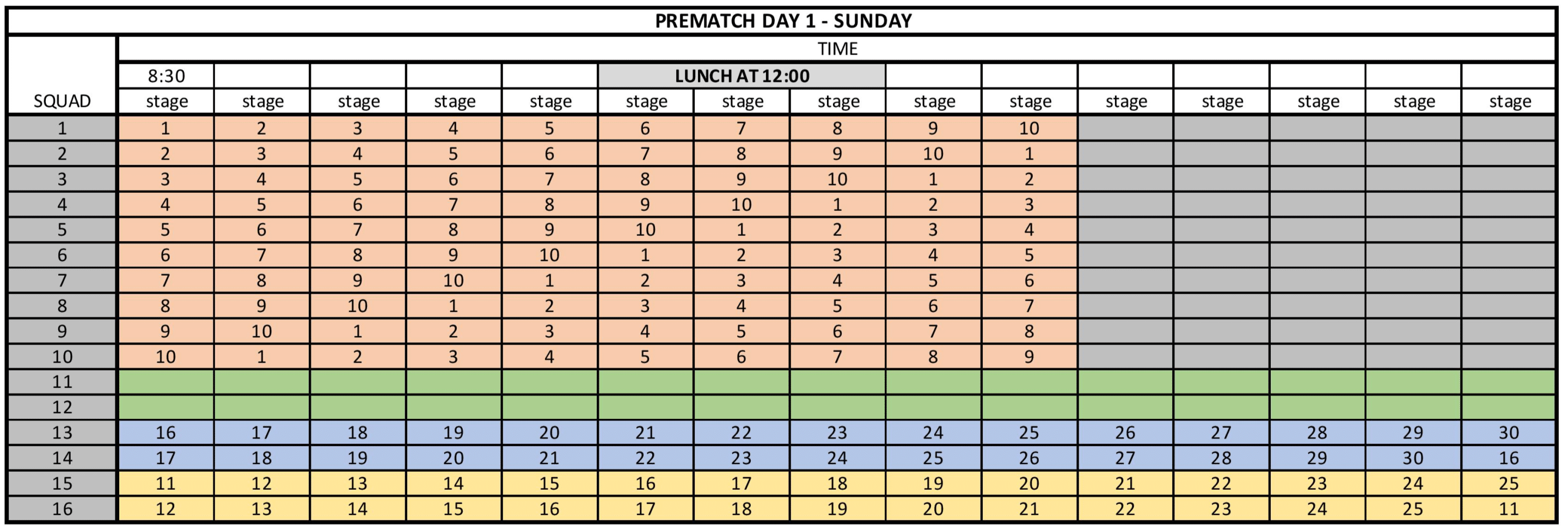

Prematch 2027 :
we start each day at 8:30
Time Schedule main match 2027
please always check info board at entrance of shooting range for latest info
